Guide

MoSCoW prioritization, with one release worked through request by request

Four buckets, one blunt question and a cap most teams skip. Here is the method from its source, then applied to twelve real-looking feature requests.

By Martin Lasek · Oct 5, 2026 · 9 min read

MoSCoW prioritization

MoSCoW prioritization sorts everything you could build into four buckets: Must have, Should have, Could have and Won't have this time. It is one of the most common ways to decide what goes into a release with a fixed date, and you will also see it called the MoSCoW method, MoSCoW analysis or the MoSCoW technique.

Most guides stop at the four definitions. This one takes the rules from their source, then sorts twelve feature requests for one release, including the mistake nearly every team makes on the first pass. Plant Diary is a made-up app for the example.

The short answer

Give every item one of four labels. Must have is anything without which the release makes no sense. Should have is important but survivable with a workaround. Could have is nice to have and the first thing you drop when time runs out. Won't have this time is explicitly out of this release. Then check the effort: DSDM, the agile framework that made MoSCoW popular, recommends that Must Haves take no more than 60% of the work and that Could Haves make up about 20%.

Where MoSCoW comes from

According to TechTarget, "Software development expert Dai Clegg created the MoSCoW method while working at Oracle". It spread through DSDM, an agile framework now maintained by the Agile Business Consortium, whose handbook still has the clearest rules. The two lowercase o's mean nothing. They only make the acronym pronounceable.

DSDM even reads MUST as a backronym:

"These provide the Minimum Usable SubseT (MUST) of requirements which the project guarantees to deliver."

Agile Business Consortium, What is MoSCoW Prioritization?, accessed October 5, 2026

The four buckets

Must have

The release fails without it. DSDM's test is one question: "what happens if this requirement is not met?" If the honest answer is that you would cancel or postpone the release, it is a Must. Its other signs are "Not legal without it", "Unsafe without it" and "Cannot deliver a viable solution without it". And the escape hatch is written right into the rule:

"If there is some way around it, even if it is a manual and painful workaround, then it is a Should Have or a Could Have requirement."

Agile Business Consortium, What is MoSCoW Prioritization?, accessed October 5, 2026

Should have

DSDM defines these as "Important but not vital" and "May be painful to leave out, but the solution is still viable". Users will notice and some will complain, but the release still does its job.

Could have

"Wanted or desirable but less important". Could Haves are your safety margin. When the deadline is at risk, they go first, which is exactly why you want some in every release.

Won't have this time

The bucket teams skip, and the one that saves the most arguments. Writing down what you are not doing ends the discussion for this release, and DSDM names the reason: "This avoids them being informally reintroduced at a later date." The words "this time" matter. A Won't is a decision about this release, not a verdict on the idea.

A worked example: one release, twelve requests

Plant Diary is planning version 2.0. One developer has eight weeks, so 40 days of work, and the date is fixed: the release has to be out before spring, when people buy new plants. On the table are eleven feature requests from the app's feedback board, each with its vote count, plus one bug from support. Every item has a rough estimate in days.

The first pass, where everything is a Must

The first sort went the way it usually goes: everything with more than 20 votes became a Must, plus the bug. That made eight Musts and 70 days of guaranteed work for a 40 day release. At that point MoSCoW is just a wish list with labels, because there is nothing left to drop when time runs out.

The second pass, with the cancel test

Asked properly, "would we cancel 2.0 without it?" leaves three Musts. The bug, because reminders are the app's one job. Custom watering intervals, the most requested item and the release headline. And sync across devices, which was announced as the other half of 2.0. Everything else has a workaround, even the widget with 51 votes.

Between Should and Could, DSDM suggests weighing how many people a gap would hurt:

"One way of differentiating a Should Have requirement from a Could Have is by reviewing the degree of pain caused by the requirement not being met, measured in terms of business value or numbers of people affected."

Agile Business Consortium, What is MoSCoW Prioritization?, accessed October 5, 2026

Vote counts are a direct measure of "numbers of people affected", so the split falls out of the board: the widget, fertilizer reminders and dark mode are Shoulds, while the photo diary, the CSV export and the German translation are Coulds. Three requests land in Won't this time, including plant identification by photo with 33 votes. It has more demand than any Could, but at 20 days it would eat half the release on its own.

Request Votes Days MoSCoW Why
Fix double reminders12 reports2MustReminders are the app's one job. Shipping 2.0 with this bug makes no sense.
Watering intervals646MustThe most requested item and the headline of the release.
Sync across devices4714MustAnnounced as the other half of 2.0. Without it the release breaks its promise.
Home screen widget515ShouldMany people want it, but the app works fine without it.
Fertilizer reminders412ShouldPainful to leave out for a lot of users, cheap to build.
Dark mode383ShouldClear demand, and cheap at three days.
Plant photo diary195CouldNice to have. Fewer people asked.
Export to CSV91CouldSmall audience, small effort.
German translation72CouldFew requests so far.
Plant ID by photo3320Won'tReal demand, but it alone would eat half the release.
Apple Watch app2215Won'tA project of its own. Recorded for a later release.
Share with a partner1812Won'tNeeds accounts first. Out of scope this time.

Then check the effort

Must Haves now take 22 of the 40 days, which is 55%. The Shoulds take 10 days and the Coulds 8, so 20% of the release is contingency, right where DSDM wants it. The three Won'ts don't count toward the 40 days at all.

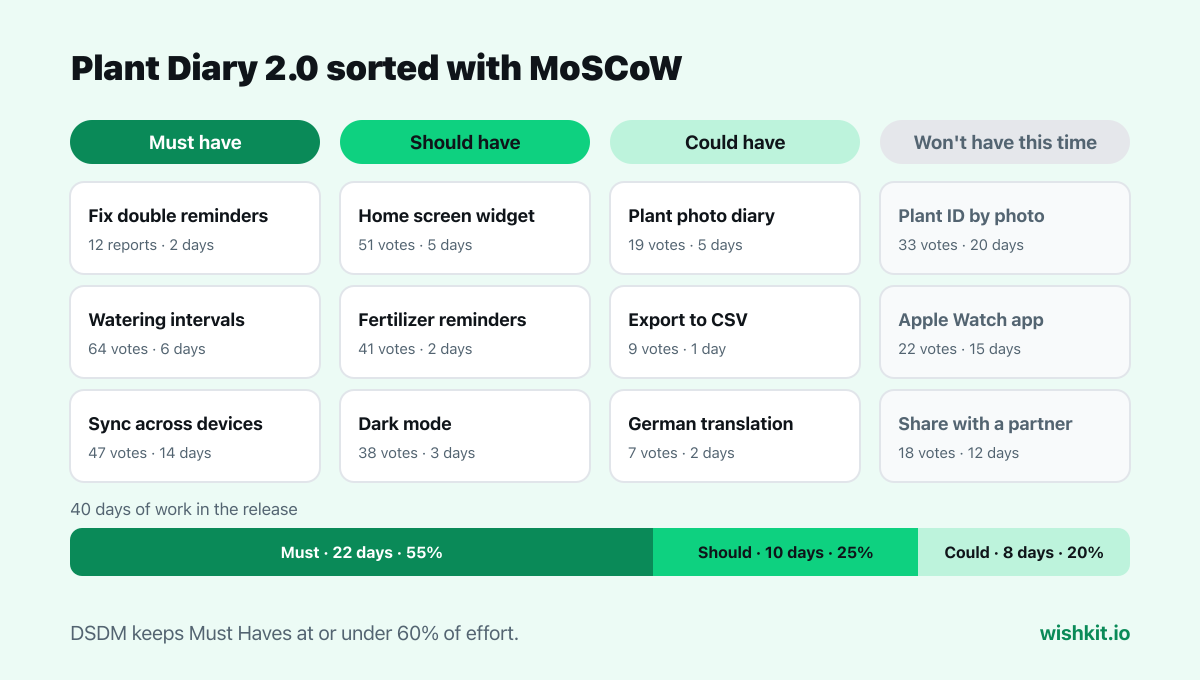

MoSCoW prioritization example: twelve feature requests sorted into Must, Should, Could and Won't have, with Musts at 55% of a 40 day release

"The safe percentage of Must Have requirements, in order to be confident of project success, is not to exceed 60% Must Have effort."

Agile Business Consortium, What is MoSCoW Prioritization?, accessed October 5, 2026

If the dark mode estimate turns out wrong halfway through, the plan already says what happens: the Coulds go first, and the three Musts still ship on time.

Common MoSCoW mistakes

A MoSCoW template you can copy

A spreadsheet with five columns is all you need. Fill it in this order:

Column What goes in it
RequestOne line per feature request, bug or task, in the words of whoever asked.
Votes or who askedHow many people want it, or which customers. This settles Should versus Could.
EffortA rough estimate in days. Precise enough to check the 60% cap.
MoSCoWMust, Should, Could or Won't. Musts only after the cancel test.
WhyOne sentence. It ends the same discussion next week.

Then two checks: the Must days add up to no more than 60% of the days you have, and the Coulds add up to about 20%. If the Musts are over, one of them isn't really a Must.

Where the votes come from

The example works because every request came with a vote count. Without one, "numbers of people affected" is a guess, and the loudest person in the room decides what is a Should. A feature request board collects those numbers for you: users post ideas, vote on each other's, and the count is there when you plan. WishKit does that for apps and websites, and the steps of collecting requests are in how to collect and prioritize feature requests.

Votes don't make Musts, though. A request can have 33 votes and still be a Won't this time, and a bug nobody voted on can be the most important Must. The cancel test decides what is a Must. The votes settle everything below it. If you need a strict order rather than buckets, RICE prioritization turns the same votes into a score. To tell a basic people expect from a nice extra, the Kano model asks your users directly. All five frameworks are compared on this same list in the guide to feature prioritization.

Frequently asked questions

What does MoSCoW stand for?

Must have, Should have, Could have and Won't have this time. The o's carry no meaning and only make the word pronounceable. DSDM also reads MUST as Minimum Usable SubseT, the part of the release that is guaranteed.

Who created the MoSCoW method?

Dai Clegg, while he was working at Oracle. It became widely used through DSDM, an agile framework now maintained by the Agile Business Consortium.

What percentage of a release should be Must have?

No more than 60% of the effort, according to DSDM, with about 20% in Could Haves as contingency. Won't Haves don't count toward the total.

What is the difference between Should have and Could have?

How much it hurts to leave it out. DSDM suggests measuring that in business value or the number of people affected, which is what vote counts on a feature request board give you.

Does Won't have mean the feature will never be built?

No. It means not in this release. Keeping the Won't list visible stops the items from sneaking back in, and it is the natural starting point for the next planning round.

Is MoSCoW an agile method?

It comes from DSDM, which is an agile framework, and it fits sprints well. DSDM applies it at three levels: the whole project, each increment, and each timebox.
